BY FILIPPO PEDRETTI
Nuclear’s Role in the Power Mix Hangs in the Balance;
Tomari NPP as a Case Study
In the last decade, Japan has restarted a third of its nuclear reactors. To hit the government targets for the sector within the power mix, and help play a role in cutting the nation’s emissions, at least another third of the reactors have to come back online.
The problem is, the updated regulatory environment and the need for a social buy-in has arguably made each new restart in Japan harder, not easier. Even a new nuclear facility, such as the third unit of the Tomari NPP, on the northern island of Hokkaido, has spent over three times as long under regulatory review than in operation.
As Japan seeks to overhaul and decarbonize its energy sector, nuclear power has been allocated an important role by the government. The traditionally CO2-free, stable and low-cost electricity from the NPPs is seen by officials as also supporting the recent local revitalization of the semiconductor sector.
While METI is keen to retain nuclear power as ideally providing 20-22% of the nation’s electricity, the deliberations of officials over the next Basic Energy Plan have to take into consideration a stark reality: Restarting an NPP in Japan is not just hard, it’s unpredictable. Prime Minister Kishida has already failed to deliver on the quick restarts promised two years ago. This raises the question as to how much should state and business officials rely on nuclear energy in 2030 and beyond.
Japan NRG will review the situation around the Tomari NPP as a case study into the factors that are driving the nuclear restart story.
Historical context and current status
Before the 2011 Tohoku earthquake and Fukushima Daiichi NPP disaster, nuclear power was a pillar of Japan’s energy mix, at just less than 30% of the total. The nuclear accident led to the halt of all the reactors, bringing nuclear power’s share to zero by 2013. To compensate for the loss, Japan has since relied mostly on coal and natural gas, as well as rapidly developing its solar capacity.
In 2015, Japan restarted the two units of Sendai NPP on the island of Kyushu, under new safety rules. But after an initial spurt of restarts in Kyushu and the Kansai region, progress ground to a halt. Most of the nuclear plants that remain under regulatory review today have some long-standing issues from a technical or community perspective.
The sector’s fortunes, however, took a turn for the better in 2022. After a sharp spike in fossil fuel prices following Russia’s incursion into Ukraine, concern about energy security and costs helped bring public approval of restarts above the 50% level for the first time since the Fukushima disaster. This made it more palatable for local politicians to green-light restarts, and encouraged METI to bring out the first roadmap for building new nuclear plants and technologies in over a decade.
While the share of nuclear in the electricity mix has ticked up close to double digits last year, from about 5.5% in FY2022, and nuclear’s 20-22% share of the 2030 power mix was confirmed by the GX Decarbonization Power Supply Bill, the actual pace of restarts has been painful.
This year, only Shimane NPP Unit 2 and Onagawa NPP Unit 2 are expected to restart; the first in August, the second in September. This will add about 1.6 GW.
Currently, 12 reactors are operational in Japan, with a total capacity of 11.6 GW. Last year, nuclear contributed 81.08 TWh of the total electricity consumption of 851.12 TWh. OCCTO expects power demand to hover around 857 TWh in 2031. For nuclear to hit its 20-22% share, based on today’s consumption figures and average reactor run rate, Japan NRG estimates that another 14.2 GW of capacity needs to be put online.
Depending on reactor size, that can mean the restart of a further 10-16 units. There are only 33 reactors that qualify as operable in the country, although not all of these have even applied for NRA review. Another three units are listed as “under construction”, and one of those recently won funding via the long-term decarbonization power source auction (LTDA).
Today’s hot topic
One of the biggest restart debates today is around TEPCO’s Kashiwazaki-Kariwa NPP. For starters, it is equipped with boiling water reactors (BWRs). The reactors at Fukushima Daiichi were BWRs. Of Japan’s 33 reactors, 17 are BWRs and the rest are pressurized water reactor (PWR) designs. If a unit at Kashiwazaki-Kariwa were to restart, it would be the first BWR to be brought online since the 2011 disaster, and it would also be the first operated by TEPCO.
Other reactors under the microscope include Japan Atomic Power’s Tokai No. 2 in Ibaraki Prefecture and Tsuruga NPP Unit 2 in Fukui Prefecture. For the former, there’s no clear outlook for a restart due to issues with evacuation plans and a halt-of-operations order issued by a district court. The latter has been undergoing NRA reviews since 2015.
Case study: Tomari NPP
Hokkaido’s only nuclear power generation capacity, Tomari NPP, is among those awaiting restart. Units 1 and 2 have a capacity of 579 MW each; Unit 3 has a capacity of 912 MW.
Commissioned in 2009, Unit 3 was in the last phase of regular inspections at the time of the 2011 earthquake and tsunami. In August of that same year, it became the first reactor to restart after the disaster, but after a regular inspection began in 2012 it has remained offline.
Alongside other operators, in 2013 Hokkaido Electric applied to the NRA to review the Tomari facility under the new, improved safety criteria. While many of the Kansai and Kyushu reactors passed the reviews, Tomari remains under regulatory scrutiny 11 years later.
Status of nuclear reactors in Japan
Restarted | Passed review | Under review | Under construction | Planned | Not applied to NRA | Slated for decommissioning since 2011 |
Mihama NPP Unit 3, Ohi NPP Unit 3, Ohi NPP Unit 4, Takahama NPP Unit 1, Takahama NPP Unit 2, Takahama NPP Unit 3, Takahama NPP Unit 4, Genkai NPP Unit 3, Genkai NPP Unit 4, Sendai NPP Unit 1, Sendai NPP Unit 2, Ikata NPP Unit 3 | Kashiwazaki-Kariwa NPP Unit 6, Kashiwazaki-Kariwa NPP Unit 7, Shimane NPP Unit 2, Onagawa NPP Unit 2, Tokai No.2 NPP
| Shika NPP Unit 2, Tsuruga NPP Unit 2, Higashidori-Tohoku NPP Unit 1, Tomari NPP Unit 1, Tomari NPP Unit 2, Tomari NPP Unit 3, Hamaoka NPP Unit 3, Hamaoka NPP Unit 4,
| Ohma NPP Unit 1, Higashidori-Tokyo NPP Unit 1, Shimane NPP Unit 3
| Tsuruga NPP Unit 3, Tsuruga NPP Unit 4, Higashidori Tohoku NPP Unit 2, Higashidori – Tokyo NPP Unit 2, Kaminoseki NPP Unit 1, Kaminoseki NPP Unit 2, Sendai NPP Unit 3, Hamaoka NPP Unit 6 (construction deferred indefinitely)
| Onagawa NPP Unit 3, Hamaoka NPP Unit 5, Shika NPP Unit 1, Kashiwazaki-Kariwa NPP Unit 1, Kashiwazaki-Kariwa NPP Unit 2, Kashiwazaki-Kariwa NPP Unit 3, Kashiwazaki-Kariwa NPP Unit 4, Kashiwazaki-Kariwa NPP Unit 5
| Onagawa NPP Unit 1, Fukushima Daiichi NPP Unit 1, Fukushima Daiichi NPP Unit 2, Fukushima Daiichi NPP Unit 3, Fukushima Daiichi NPP Unit 4, Fukushima Daiichi NPP Unit 5, Fukushima Daiichi NPP Unit 6, Fukushima Daini NPP Unit 1, Fukushima Daini NPP Unit 2, Fukushima Daini NPP Unit 3, Fukushima Daini NPP Unit 4, Tsuruga NPP Unit 1, Mihama NPP Unit 1, Mihama NPP Unit 2, Ohi NPP Unit 1, Ohi NPP Unit 2, Shimane NPP Unit 1, Ikata NPP Unit 1, Ikata NPP Unit 2, Genkai NPP Unit 1, Genkai NPP Unit 2 |
Source: Institute of Energy Economics Japan, International Atomic Energy Agency, Japan Nuclear Safety Institute
Tomari’s problems are several. First, the plant failed to provide explanations regarding safety measures, apparently due to there not being sufficient staff capable of handling safety procedures. The NRA claims that the plant does not have enough trained experts who can discuss issues related to the threat posed by tsunamis and earthquakes. Hokkaido Electric has since pledged to train such specialized personnel.
Another issue was the construction of a seawall at the plant as tsunami defense. In 2022, the Sapporo District Court ruled that Hokkaido Electric should not operate the plant due to a lack of safety assurances over the solidity of the ground underneath the 16.5-meter seawall. The decision came after about 1,000 plaintiffs filed a lawsuit in 2011 to request the plant’s decommissioning.
Hokkaido Electric was requested to rebuild its seawall on solid bedrock. The new version is expected to be 19 meters high, 30 meters wide, and 1,200 meters in length. The company has completed soil reinforcement. At the end of April, the NRA visited the plant and found no issues with the seawall work or with reactor-related equipment at the site.
Rising costs and demand
The cost of upgrading Hokkaido Electric’s seawall was around ¥180 billion. A further ¥200 billion was spent on other safety improvements to allow for a restart. And yet, NRA reviews and public safety assessments continue. Hokkaido Electric had hoped to restart Unit 3 by December 2026, but this date is earlier than the estimated timeframe for completion of the new seawall (2027).

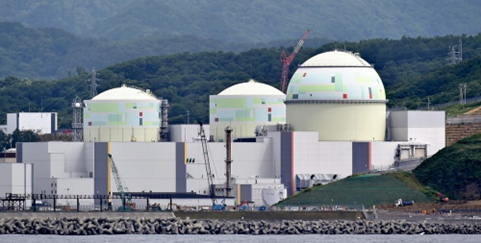

Tomari NPP. Source: Yomiuri Shimbun
This June, the company is due to give an update of Tomari’s status to the NRA. Originally, such a report was scheduled for January; it was subsequently delayed, twice, due to problems in preparing the necessary explanations for new tsunami-related preventive measures.
The company also has to train new plant operators. Given that Tomari has been offline since 2012, just over half of its current employees reportedly have no experience of running a reactor beyond training on simulators. This is a problem common to other NPPs.
The timing of Tomari’s restart is critical not only for Hokkaido Electric. Semiconductor producer Rapidus aims to begin full-scale operations of its factory in Chitose, Hokkaido in 2027. Rapidus plans to rely on renewable energy but considers CO2-free electricity from Tomari a vital backup.
Notably, Taiwanese semiconductor manufacturer TSMC chose to establish its first Japanese factory in Kumamoto, which is the only region in the country with high nuclear and renewables volumes.
Adherence to safety is paramount
Of course, one way to sell a skeptical public on the need for nuclear restarts is the price of electricity. Rate payers in Hokkaido, which currently has no reactors online, pay an average of ¥9,523 per household. Those in Kansai, which relies on nuclear power more than other regions in Japan, pay ¥7,664; in Kyushu it’s ¥7,551.
Still, the promise of lower bills alone won’t be enough. Regional and local politicians, who need to sign off on a restart, fear public blowback in case of accidents more than economic hardships. This year’s Noto Earthquake spooked some officials.
Unless the public and political resolve changes, the current pace of restarts will not allow the nation to hit its 2030 nuclear targets. Beyond that, from the late 2030s, the licensing terms of existing units will start to expire.
In practical terms, nuclear operators and energy planners have until the end of this decade to show that the industry’s decline can be reversed, which begins by accelerating the pace of restarts. If not, the only option remaining would be to rethink the energy strategy itself.
BY MAGDALENA OSUMI
How Sinking Auction-based Power Rates Are Impacting
PV Generators in Japan
Japan’s national strategy calls for more solar energy in the nation’s power mix. But many of the smaller businesses that helped build the sector from scratch a decade ago say the returns are no longer attractive.
Additional regulation, a shift towards market-based pricing, and the need to commit to greater community engagement no longer make solar projects economically feasible for smaller operators. Meanwhile, an industry consolidation trend via M&A and increased private equity inflows are changing the structure of the domestic solar sector.
Current energy policy envisions about one-fifth of the nation’s mix eventually coming from solar power, which became a priority in the wake of the 2011 nuclear disaster. While the rollout of new projects has slowed recently, solar is still described by the government as one of the main drivers of additional power capacity this decade.
This year, with the update of the Basic Energy Plan, the status and future development of the solar sector is expected to be updated. As well as addressing the fact that the current rollout lags previously set 2030 targets, METI is expected to touch on the impact of new solar tech such as flexible / Perovskite solar cells (PSC) and the contributions from solar PVs on water, rooftops and other facilities.
Still, for many operators, the main questions will be about price. The government has been on a relentless drive to push solar tariffs lower. But with land availability decreasing and other above-mentioned challenges pushing costs upward, can Japan afford to squeeze the smaller renewables firms any further?
Potential growth
Since Japan began to shift away from fossil fuels, the country has seen a tenfold increase in installed solar power, from an estimated 5.6 GW as of June 2012 to around 56 GW of capacity in operation as of March 2021. The installed capacity was even higher at 75.5 GW, and two years later that grew to 87 GW (DC) or 71 GW (AC). Of the latter AC number, however, 8.9 GW was not classified as operational as of March 2023.
The Japan Photovoltaic Energy Association (JPEA) says there’s still room to expand solar power in the country. Technically, it calculates that it’s possible to introduce as much as 2.38 TW of solar in Japan, which suggests that only 3-4% of the potential is tapped to date.
In 2023, solar’s share in the national energy mix was 11.2%, while the ratio of all renewables in the energy mix rose to 25.7%. The latter is supposed to hit 36-38% by 2030, according to the current Basic Energy Plan, but it will be updated – with new 2040 guidance – before March 2025.
Switching to market pricing
Ten years of solar capacity rollout were funded through a Feed-in-Tariff (FIT) system, in which prices were guaranteed. Over this time, the FIT offered by the government fell significantly, compressing margins. However, this isn’t the only factor operators today have to contend with.
In April 2022, the government switched the majority of solar projects to the Feed-in-Premium (FIP) system, in which payment depends in part on the market price of electricity. The goal is to incentivize solar operators to move the sector to a more market-based business model, rather than a state-subsidized one, but also to encourage investments in additionalities such as batteries for energy storage.
Given the additional complexity, the FIP was introduced at a more generous range of between ¥12 and ¥14/ kWh, more than was offered for commercial and industrial systems under FIT. Within about a year, however, FIP auction prices dropped dramatically, with some bidders giving away their right to earn a premium under this mechanism and setting their bid at ¥0.
Essentially, these zero-yen bids were using the FIP mechanism to secure a grid connection, while agreeing to take on all the commercial risk of negotiating electricity sales contracts.
The auctions for FIT / FIP projects are overseen by state-run Organization for Cross-regional Coordination of Transmission Operators (OCCTO), and are open to solar systems over 250 kW in size. OCCTO holds several auction rounds each year, with four slated this year.
While OCCTO auctions continue to draw interest from the industry, the number of bidders is noticeably shrinking.
Last year, OCCTO’s 16th solar auction round in July 2023, the first that year, concluded with 119.7 MW of capacity being awarded FIP contracts, more than what was initially offered. But the price cap was depressed further to ¥9.5/ kWh. As a result, the average weighted winning price was just ¥9.34/ kWh. The lowest winning bid hit ¥9/ kWh.
This led to an outcry in the broader industry. According to JPEA, 81% of its solar operator members said that they would struggle to generate electricity at a profit from PV panels alone under such conditions. Industry players also pointed to a widening gap between the price and rising supply costs and want government procurement prices to rise by ¥2-3/ kWh.
Instead, prices have continued to drop. In subsequent OCCTO auction rounds, bids hit as low as a range of ¥0 and ¥6.98/ kWh. Meanwhile, OCCTO has used the opportunity to lower the price cap each time until it dipped to ¥8.98 by the end of FY2024.
Winners and losers
For the bigger solar players, the changing circumstances have led to a change in strategy. Developers have either sought greater scale, including through mergers or capital infusions from private equity etc, or evolved their business model to try their hand in battery storage, or wind power, or other clean energy directions.
Within just the last year or so, several new ‘platform’ businesses have entered Japan’s solar market, such as Nozomi Energy (backed by British investment firm Actis), with even more new entrants in the battery space but with aspirations to eventually expand the green portfolio (Hexa Renewables, backed by I Squared Capital; CHC Energy, backed by Stonepeak, etc).
Similar consolidation has taken place among domestic investors, with Toyota Tsusho and Orix among the biggest buyers of solar and wind projects in Japan.
The scale of these growing operations has made them more aggressive in seeking out better prices under corporate power purchase agreements (PPAs) or by building out a merchant business aligned with Japan’s burgeoning electricity market platforms. Securing connectivity to the grid, even via a zero-yen auction, is worth more than tariff income, a luxury that smaller developers without the resources to negotiate PPAs or trade electricity cannot afford.
In late May, one of the world’s biggest tech giants Google announced two solar PPAs in Japan that will add a combined 60 MW of solar capacity to the Japanese grid. Google signed the contract with one of the largest trading houses, Itochu, and Shizen Energy, a leading domestic renewables developer. With the agreements, Google will procure renewable energy generated at the farms across Japan.
According to estimates based on physical PPAs, developers were selling electricity and environmental attributes (also known as “green tags,” or “renewable-energy credits”) to retailers in Japan at ¥11-12/ kWh for solar projects launched in 2022. Today, these numbers are often several yen higher, and more.
Go big or go home
The consolidation of the solar industry should eventually help to revive the rollout of new capacity in Japan and the appetite of private equity and Big Tech offtakers are among the accelerator factors for the market.
The government, however, will need to consider whether it should throw the smaller solar developers a lifeline. Big business is perhaps more likely to help drive the big renewables expansion that the Basic Energy Plan calls for. But solar development is also a ‘local’ business, in which people connections are vital to securing land and community buy-in. Disenfranchising local developers may cause more issues than it solves.
BY JOHN VAROLI
This weekly column focuses on energy events in Asia and the Pacific
Australia / Rooftop solar and BESS
Nexa Advisory recommended the New South Wales govt to increase uptake of rooftop solar and battery energy storage systems (BESS) by the commercial and industrial sector. This could capture 7 GW of additional power and help build grid reliability.
China / Offshore wind
Mingyang Smart Energy and Germany’s BASF received approval from China for a 500 MW offshore wind farm off the coast of Guangdong province that they are co-developing. The JV is 90% owned by Mingyang and 10% by BASF. It’s the first and only Chinese-German offshore wind project.
China / Wind turbines
State-owned power generator manufacturer Dongfang Electric Corp said it successfully installed an 18-MW offshore wind turbine, which is now considered to be the largest in use globally.
Malaysia / Fuel subsidies
The govt introduced targeted retail diesel fuel subsidies in an effort to end its costly blanket fuel subsidy program. The govt hopes this will strengthen its finances amid economic difficulties and high oil prices.
Northeast Asia / Weather
Since June 8, high temperatures have persisted in North China and the Koreas. The highest temperatures in some areas of southern Hebei and northern Shandong exceeded 40°C.
Nuclear power
Asia will dominate nuclear power installations over the next 10 years, comprising 88% of the projected 55.6 GW new projects from 2024 to 2033, said BMI. The region will see over 49 GW of new capacity growth. Nuclear is key for the low-carbon energy efforts of China and India.
Oil surplus
The world faces a “staggering surplus” of oil as companies boost production, thwarting OPEC+ efforts to manage crude prices, said the IEA. Demand is forecast to peak by 2030.
Pakistan / LNG
Pakistan is unlikely to buy LNG cargoes on the spot market until at least November due to oversupply and high prices, the country’s oil minister told Reuters.
Philippines / Renewables
Energy company ACEN Corp plans to raise $15 billion. This is part of its 2030 target to increase renewables capacity from 5 GW to 20 GW. This capital will be a mix of debt and equity.
Sri Lanka / Nuclear power
The IAEA finished a seven-day safety review of Sri Lanka’s selection process to choose sites where the country could build its first nuclear power plant. Six potential sites have been identified.
A selection of domestic and international events we believe will have an impact on Japanese energy
|
January |
|
|
February |
|
|
March |
|
|
April |
|
|
May |
|
|
June |
|
|
July |
|
|
August |
|
|
September |
|
|
October |
|
|
November |
|
|
December |
|
Disclaimer
This communication has been prepared for information purposes only, is confidential and may be legally privileged. This is a subscription-only service and is directed at those who have expressly asked K.K. Yuri Group or one of its representatives to be added to the mailing list. This document may not be onwardly circulated or reproduced without prior written consent from Yuri Group, which retains all copyright to the content of this report.
Yuri Group is not registered as an investment advisor in any jurisdiction. Our research and all the content express our opinions, which are generally based on available public information, field studies and own analysis. Content is limited to general comment upon general political, economic and market issues, asset classes and types of investments. The report and all of its content does not constitute a recommendation or solicitation to buy, sell, subscribe for or underwrite any product or physical commodity, or a financial instrument.
The information contained in this report is obtained from sources believed to be reliable and in good faith. No representation or warranty is made that it is accurate or complete. Opinions and views expressed are subject to change without notice, as are prices and availability, which are indicative only. There is no obligation to notify recipients of any changes to this data or to do so in the future. No responsibility is accepted for the use of or reliance on the information provided. In no circumstances will Yuri Group be liable for any indirect or direct loss, or consequential loss or damages arising from the use of, any inability to use, or any inaccuracy in the information.
K.K. Yuri Group: Hulic Ochanomizu Bldg. 3F, 2-3-11, Surugadai, Kanda, Chiyoda-ku, Tokyo, Japan, 101-0062.
NEWS
・Japan explores recycling mandate for solar panels as disposal is set to peak in mid 2030s
・Nippon Steel makes first shipment of green steel tubes, to Qatar’s blue ammonia plant
・Honda Motor and Mitsubishi set up firm to utilize used EV batteries for the power grid
